Works and Stoppages Programme 2026/2027
Find out more about plans for maintenance, repair and development of Scotland's canal network this coming winter

Â
Our Engineering & Assets Team carries out routine inspections of all the heritage assets on the canal network. With so much of our infrastructure built more than 200 years ago, there are a variety of issues that can affect them as they age, requiring close monitoring, maintenance, and repairs. Â
The task of monitoring the structures is carried out by a team of asset inspectors who visit and assess the condition of:
- The five canals themselves (embankments, locks, gates and mechanisms) extending over 141 miles
- The network's 19 feeder reservoirs (including sites as iconic as Loch Ness!)
- Engineering assets, including 62 historic aqueducts
- As well as bridges, weirs, feeder channels, lock bypasses and culverts
- Towpaths and access routes, the canal estate and properties, lighthouses and landscaping
Our assets are important places for people and nature while also playing vital roles in the management of water through our landscapes. Many of our major towns and cities, as well as rural centres, were built around the canal network in the late eighteenth and nineteenth centuries. Having evolved along the banks of the canals, these settlements have dependencies upon the canal and reservoir network for their water management.Â
As climate change begins to affect our rural and urban landscapes, the role of the canals is changing too. Through partnerships with local authorities, Scottish Water and other public bodies, we are finding innovative ways to use the network for additional drainage and flood mitigation, as well as supporting management of water quality in neighbouring burns and rivers.
Winter is the busiest time for works on our canal network as we seek to minimise disruption during the boating season. You can find details of upcoming stoppages and towpath diversions on the network over the winter of 2026/2027 below.Â

View Current Works and Stoppages on our Network Map
You can view the status of our main assets (canals, aqueducts, and locks) on the canal network map. Click on the icons to learn more about each feature and any restrictions to navigation currently in place. Stoppages in this winter's programme will be marked on our map in red as soon as they are implemented.
View the full schedule of works and stoppages by canal
THE FORTH & CLYDE CANAL

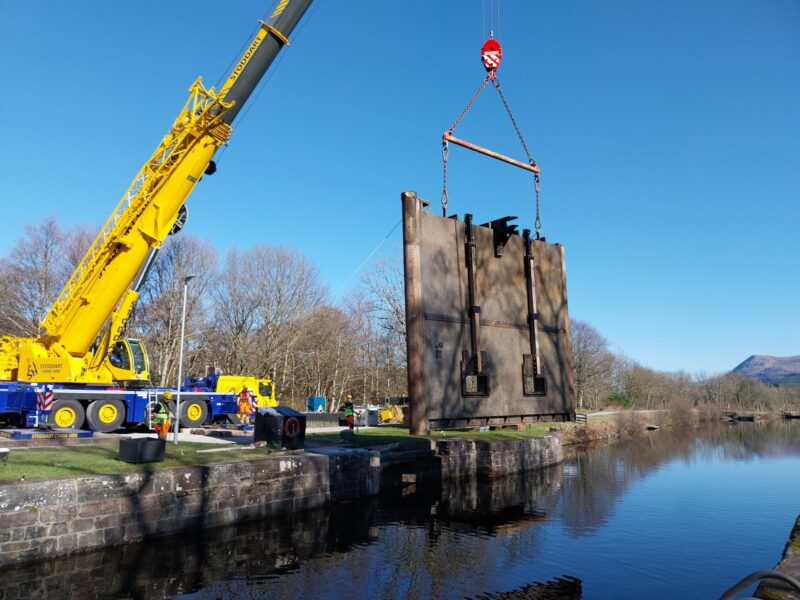

Falkirk Flight, Lock Gate Replacement, Repair and Upgrade Programme, March 2025 to 23rd April 2027 - navigation suspended and towpath diversions
Reason: Replacement of 12 sets of lock gates that have reached the end of their operational lifetimes with installation of a lock bypass (Lock 16 Camelon); masonry, embankment and auxiliary repairs.
Impacts on navigation/towpaths: Navigation is suspended from Lock 3 (Grangemouth) to Lock 16 (Camelon); towpath diversions are in place.Â
Dates: March 2025 - 23rd April 2027
Find out more: Projects | Falkirk FlightÂ
Kelvin Aqueduct - Repair Programme, February 2026 to 1st March 2027 - navigation suspended and towpath diversion
Reason: Work to investigate, mitigate then repair a leakage on the aqueduct.
Impacts on navigation/towpaths: Navigation is suspended between Lock 21 (Maryhill) and Bowling - Bowling Harbour remains open. There is a towpath diversion in place around the Kelvin Aqueduct and the diversion will be extended to the Maryhill locks on 23rd November for the Lock 21 bypass installation project to commence.Â

Dates: 9th February 2026 - 1st March 2027
Find out more: Projects | Kelvin Aqueduct
Lock 20 (Wyndford) Bypass Installation, 31st August - 30th November 2026 - towpath diversion
Reason: Final phase of works related to the installation of a lock bypass as part of the enabling works for the Smart Canal.
Impacts on navigation/towpaths: There is a towpath diversion around Lockkeeper's Cottage.
Dates: 31st August - November 2026
Find out more: Projects | Lock 20 Bypass Installation
Lock 21 (Maryhill) Bypass Installation, 23rd November 2026 - May 2027 - towpath diversion
Reason: Installation of a lock bypass at Lock 21 (Maryhill) to improve water controls along the canal and as part of the enabling works for the smart canal.
Impacts on navigation/towpaths: Navigation is currently suspended through Maryhill locks and along to Bowling harbour (the harbour remains open) due to the Kelvin Aqueduct repair programme combined with the Lock 21 project. Once the Kelvin Aqueduct re-opens on 1st March, the Lock 21 project will continue but will have no impact on the resumption of navigation.

Dates: 23rd November 2026 - May 2027
Find out more: Projects | Lock 21 Bypass Installation
Lock 38 (Helenslea) - Emergency Gate Repairs, 24th August 2026 to Spring 2027 - navigation suspended
Reason: Emergency works to the upstream gates which are non-operable.
Impacts on navigation/towpaths: Navigation is now suspended through Lock 38.Â
Dates: 24th August 2026 (date or re-opening to be confirmed as these are emergency works)
Temporary Closure of Grangemouth Kelpies Customer Facilities, December 2026 to February 2027
Reason: The moorings customer facilities are being refurbished with repairs to the roof, installation of external lighting, repainting and repairs to timber, installation of new doors and windows, repairs to roughcast and installation of new showers, toilets, waste disposal and laundry facilities.
Impacts on navigation/towpaths: The facilities will need to close for the duration with more details and dates to be announced.
Dates: December 2026 to February 2027
Temporary Closure of the Holiday Hire Boat Car Park and Pathway (South Bank), The Falkirk Wheel, September - October 2026
Reason: Duct works will be underway.
Impacts on navigation/towpaths: No impacts on towpaths or navigation anticipated, but the holiday hire boat car park on the south bank will be closed. The footpath to the holiday hire boat cabins will also be closed for the duration. There may be some localised diversions from the turning circle to the swing bridge.
Dates: 21st September to 19th October 2026
Portdownie Road (Temporary Traffic Lights), Lock 16, September 2026
Reason: During works to transform the former AG Barr factory into Scotland's Centre for Canals & Traditional Skills, we will need to make a surface water connection from the front of the building to the canal.Â
Impacts on navigation/towpaths: No impacts on towpaths or navigation anticipated, but there will be traffic lights on Portdownie Road.
Dates: 7th to 25th September 2026
Townhead Reservoir - Replacement of the auxiliary spillway, January 2027
Reason: Replacement of the auxiliary spillwayÂ
Impacts on navigation/towpaths: No impacts on towpaths or navigation anticipated.
Dates: From January 2027
THE UNION CANAL
Cobbinshaw Reservoir Valve Repairs, September 2026 - January 2027
Reason: Enabling works ahead of spillway improvements at the reservoir.
Impacts on navigation/towpaths: No impacts on towpaths or navigation anticipated.
Dates: 21st September 2026 - 12th January 2027
Mitigation of Defects on the Almond Feeder Aqueduct, November - December 2026 - footbridge closure
Reason: Work is needed to mitigate erosion to the aqueduct structure.
Impacts on navigation/towpaths: The footbridge over the aqueduct is closed to cyclists and pedestrians with a diversion route and signage in place for the foreseeable future; temporary closure of the towpath by the aqueduct may be required during works (to be confirmed).
Dates: 9th November to 7th December 2026
Find out more: Project | Almond Feeder Aqueduct
Manse Road Bridge Repairs, November 2026 - towpath closure and road closure
Reason: Work is needed to repair the bridge following a vehicle strike.
Impacts on navigation/towpaths: To protect the public and contractor workers during the repairs, a short section of towpath will be closed with diversions marked. The entrance to Manse Road from Strawberry Bank Road will be closed.Â
Dates: 9th November to 16th November
Find out more: Project Page and Diversion Map
THE CALEDONIAN CANAL
Kytra Locks - Installation of Actuators, 14th January - 24th March 2027 - navigation suspended and towpath closure
Reason: Electric actuators are being installed on the Kytra Lock gates.Â
Impacts on navigation/towpaths: site activities will cause disruption to towpaths and navigation temporarily, more details to follow.
Dates: 14th January - 24th March 2027
Dochgarroch Retaining Wall Upgrades, November 2026 to January 2027
Reason: Installation of a material barrier to guard against falling debris at the maintenance depot.
Impacts on navigation/towpaths: More details to follow.
Dates: 30th November 2026 - 28th January 2027
Corpach Marina - Installation of Service Bollards, January - February 2027
Reason: Delivery and installation of service bollards for moorings customers.
Impacts on navigation/towpaths: Limited disruption to vehicle and pedestrian areas only. More details to follow.
Dates: 28th January 2026 - 26th February 2027
Dochfour Burn Dredging, October - November 2026 - car park closure
Reason: Dredging is a routine task on the canals - read more; dredging will take place on the high spots at the mouth of the burn.
Impacts on navigation/towpaths: The public car park at Dochgarroch will be closed and used for unloading of materials, a signed diversion route will be in place around it.
Dates: 26th October - 6th November

Kytra and Fort Augustus - Dredging, January - March 2027 - towpath closure
Reason: Dredging is a routine task on the canals - read more.
Impacts on navigation/towpaths: A towpath diversion is anticipated, more details to follow.
Dates: 4th January - 26th March 2027
Laggan - Dredging, January - March 2027 - towpath closure
Reason: Dredging is a routine task on the canals - read more.
Impacts on navigation/towpaths: A towpath diversion is anticipated, more details to follow.
Dates: 4th January - 26th March 2027
Gairlochy Swing Bridge Upgrade, dates to be confirmed
Reason: Improvements to the operation of the mechanised bridge.
Impacts on navigation/towpaths: No impacts on towpaths or navigation anticipated.
Dates: To be confirmed
THE CRINAN CANAL
Faolinn Reservoir Improvement Works, December 2027
Reason: Improvements to address the condition of the dam.
Impacts on navigation/towpaths: No impacts on towpaths or navigation anticipated.
Dates: December 2027
Loch Clachaig, Installation of Debris Boom, December 2027
Reason: Debris boom installation to protect the spillway from the bird raft.
Impacts on navigation/towpaths: No impacts on towpaths or navigation anticipated.
Dates: December 2027
Gleann Reservoir Embankment Upgrade, dates to be confirmed
Reason: Construction works to repair and improve the embankment.
Impacts on navigation/towpaths: No impacts on towpaths or navigation anticipated.
Dates: to be confirmed
Lock 14 - Installation of Pontoon, January 2027
Reason: The pontoon at Lock 14 needs to be reinstated following a rebuild of the embankment in 2025/2026.
Impacts on navigation/towpaths: No impacts on towpaths or navigation anticipated.
Dates: 11th to 29th January 2027
Locks 4 to 5 - Dredging, October 2026
Reason: Dredging is a routine task on the canals - read more.
Impacts on navigation/towpaths: No towpath or suspension of navigation anticipated, but minor disruption marked with signage may occur.Â
Dates: From 5th October
Ardrishaig Harbour - Plough Dredging, November 2026 - pontoon removal
Reason: Dredging is a routine task on the canals - read more.
Impacts on navigation/towpaths: The waiting pontoon outside the Ardrishaig sealock gates will temporarily be removed from 26th October and will not be available for the duration of the dredging. Movement and access within the harbour area may be restricted. Boats approaching the sealock may be asked to stand off until the dredger has moved out of the way. The contractor's working hours will be 8am to 8pm.
Dates: 9th - 30th November
Bellanoch Embankment - Leakage Mitigation and Pontoon Installation - January 2027 - towpath closure
Reason: Repair of the embankment
Impacts on navigation/towpaths: There will be a temporary closure of a section of towpath.
Dates: January 2027
Contact us
Please direct enquiries to the Kelvin Aqueduct Project Team at:Â enquiries@scottishcanals.co.uk, or call us on 0141 332 6936Â (Monday to Thursday 8.30am-5pm, Friday 8.30am - 4.30pm).
